Five suppliers means five of almost everything
The pitch for consolidation is always the same sentence: combine your orders and save on freight. That is true, and it is the least interesting part of it. What really changes when you put five Chinese suppliers into one shipment is the count of everything that can be billed and everything that can slip.
Ship five FOB orders separately and you are buying five of each of the following: a trucking run from factory to port, an export declaration, an origin document set, an ocean booking, and a customs entry at the far end. Most origin charges are billed per shipment rather than per cubic metre, so a two-carton order carries the same document fee, declaration fee and handling minimum as the pallet-sized one. For an ocean arrival into the US you also file an ISF per shipment, which means five filings and five separate deadlines you can miss.
Then there is the word FOB itself. Ask five suppliers what their FOB price covers and you will get at least three answers. One includes trucking, export declaration and origin terminal handling. One includes the trucking and nothing else. One has quietly priced it assuming their own forwarder takes the booking, which is a different conversation altogether. Nobody discovers the gaps until the origin invoices arrive, by which point the cargo is already on the water.
What consolidation collapses, and what it doesn’t
| Item | Shipping separately | After consolidation |
|---|---|---|
| Export declaration | One per supplier | One for the consignment |
| Origin doc and handling minimums | Charged per shipment | Charged once |
| Bill of lading | One per shipment, control split | One, consigned to you |
| ISF / entry at destination | One set each | One set |
| Free-time clock | Several, at different dates | One |
| Inbound trucking | Five runs to port | Still five runs, to the warehouse |
| Production slippage risk | Isolated per order | Shared: one late supplier delays all |
| Packing quality | Five standards | Still five, unless repacked |
The bottom rows are the honest ones. Consolidation does not make the moving parts disappear. Trucking into a consolidation warehouse in China still happens five times, and you still have five factories with five packing standards and five ways to be late. What changes is that all of it now resolves at one address on one date, where somebody can count it before the container doors close. That is the whole value, and it is also why the schedule matters more than the rate.

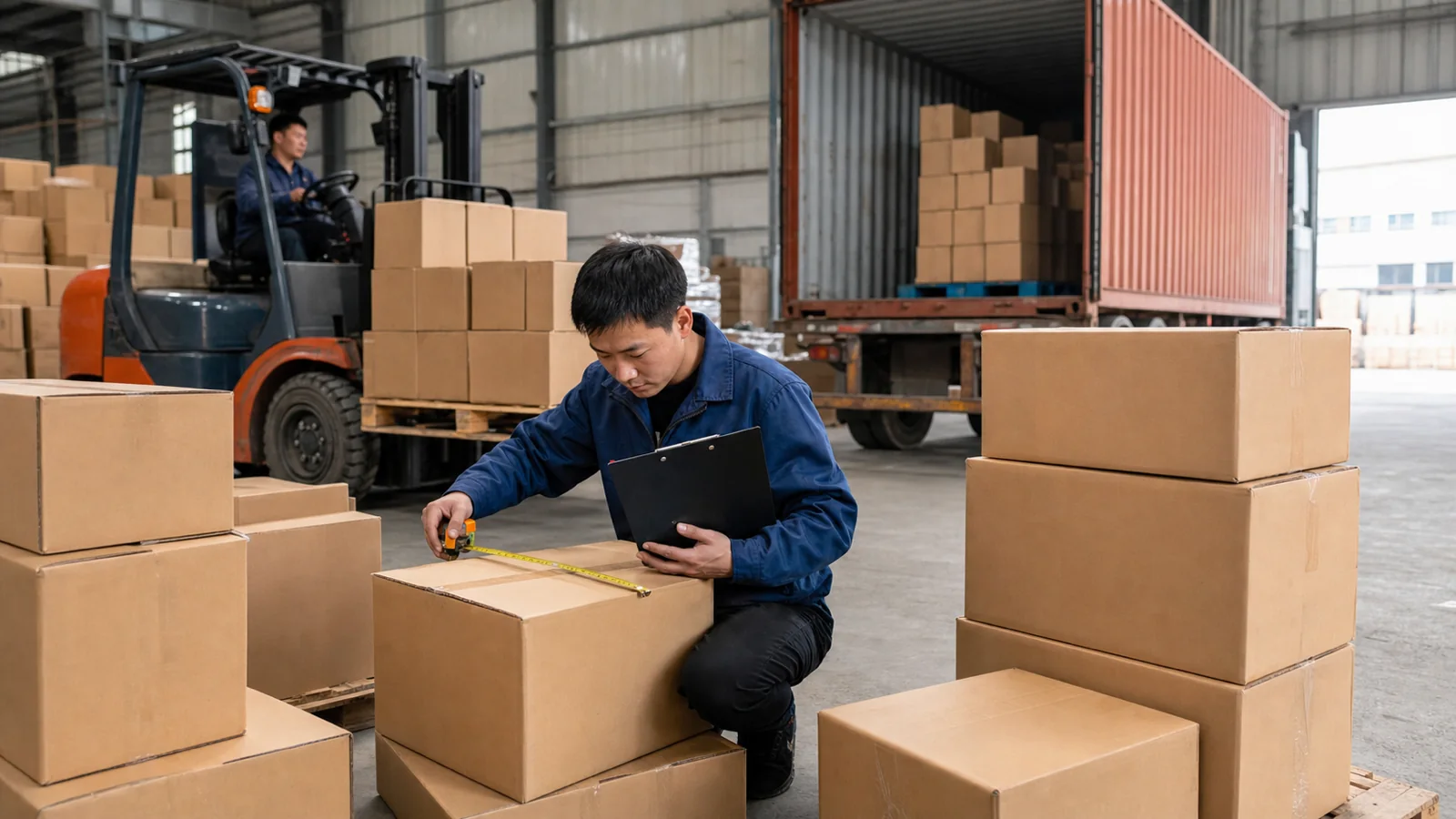

The warehouse tally is the number that resets your plan
Every supplier will give you carton dimensions. A meaningful share of those dimensions come from a spec sheet, a previous order, or an estimate made by someone in the sales office who has never handled the finished carton. Cartons grow when the factory adds a layer of foam. Master cartons get swapped when the original size is out of stock. Gross weight quoted as a round number is almost always a guess.
So the plan you built from quoted CBM stays provisional until the goods are physically measured and weighed on arrival at the warehouse. That single measurement decides three things at once: whether your total volume still fits the equipment you booked, whether you are now better off in a container than as loose LCL cargo or the other way round, and what you are actually going to be billed. LCL is charged on whichever is greater, cubic metres or metric tons, so cargo that gains weight without gaining volume can still get more expensive.
Ask for the inbound tally in a form you can act on, not as a one-line confirmation that goods arrived. Piece count, gross weight, carton dimensions measured rather than copied from the packing list, and photographs of the cartons as received. Then compare it against what the supplier told you. If the numbers move you across the line between LCL and a full container, that decision belongs before the booking cutoff, and the tradeoffs are worth reading up on before you are making the call under time pressure: see FCL and LCL ocean freight for how the two are priced differently.
One container, one declaration, one story
Here is the constraint that catches people, and it has nothing to do with freight rates. Cargo leaving China as one consignment goes out on one export declaration. That declaration names a consignor, lists HS codes and values line by line, and is filed under one trade supervision mode. Five suppliers’ goods on one container still produce one document, and someone has to be the declared exporter for all of it.
In practice there are a few normal routes. One supplier declares the whole lot, which only works if the others’ goods appear on their commercial invoice, and most suppliers will not do it. An export agent declares on everyone’s behalf, with each supplier issuing a VAT invoice to the agent, which is the common arrangement and the one that preserves each supplier’s export tax refund. Or, in designated wholesale markets such as Yiwu, the market procurement trade mode is used, which exists precisely so that many small consignors can share one container under a simplified declaration, at the cost of the VAT refund.
Now the part that surprises buyers: a single supplier who cannot or will not issue a proper VAT invoice does not just create a problem for their own cartons. It changes which declaration mode is available for the whole shipment. If four suppliers are set up for agent export with refunds and the fifth is a trading company that only issues a plain receipt, your forwarder has to either split the shipment, push the whole lot into a different mode, or leave that supplier out. Find this out while you are still negotiating, not the week before sailing. Ask each supplier two questions early: can you issue a VAT invoice, and do you export in your own name or through an agent.
The same logic follows the container to the other end. Your goods arrive on one entry. A hold placed on one line, whether it is an agency review, a valuation question or a wood packaging problem, stops the release of the container rather than just that supplier’s cartons. Untreated wood pallets from one factory can sit the whole load down. So can one line item with a value that does not survive scrutiny. Consistency across suppliers is not a paperwork nicety, it is the thing that keeps the box moving through customs clearance.
Build the calendar backwards from the cutoff
Most buyers plan forwards. Order placed, lead time added, shipment happens. That works for one supplier and falls apart with five, because the container has a fixed date attached to it and the suppliers do not.
The fixed point is the vessel. Everything else is derived from it in reverse. Note that the cutoffs are not a general rule you can memorise. They are printed on your booking confirmation, they differ by carrier, terminal and port, and they move when a vessel schedule changes. The documentation cutoff usually falls earlier than the physical cargo cutoff, which is the one people miss, because they are watching the container and not the paperwork.
| Working backwards | Derived from | Who owns it | Slack notes |
|---|---|---|---|
| Vessel departure | Carrier schedule | Carrier | The anchor. Can move earlier as well as later |
| Cargo (CY) cutoff | Booking confirmation | Forwarder / trucker | Gate queues are real. Do not plan to arrive on the hour |
| Documentation and VGM cutoff | Booking confirmation, usually earlier than CY | You and forwarder | Most commonly missed deadline in the chain |
| Export declaration filed | Port practice, before CY cutoff | Declaring party / agent | Blocked until every supplier’s invoice is in |
| Container stuffed, loading list closed | CY cutoff minus warehouse-to-port transit | Warehouse | Transit time is not slack, it is a cost of doing business |
| All cargo received, tallied, photographed | Stuffing date | Warehouse | Put your slack here, not later |
| Last supplier’s delivery into warehouse | Tally deadline | Each supplier | Give the least reliable supplier the earliest date |
| Inspection window | Before delivery, at factory or warehouse | Inspector | Rework plus re-inspection needs its own allowance |
| Balance payment triggers | Tally report or B/L copy | You | Set the trigger in the PO, not by email later |
| PO placed, deposit paid | Longest lead time before the delivery date | You | Add holiday shutdowns here or nowhere |
Two rules make this calendar hold. First, every supplier gets an individual delivery date derived from the tally deadline, not a shared one. If you tell all five to deliver by the same day, all five will deliver on that day, and your warehouse spends the afternoon measuring instead of loading. Stagger them by known reliability, earliest date to the supplier you trust least.
Second, put your slack in front of the warehouse rather than behind it. Slack that sits between the tally and the CY cutoff looks comfortable and is nearly useless, because by then the only lever you have left is rebooking. Slack that sits between the last supplier’s promised date and your tally deadline is the slack that saves a sailing. Transit time on the ocean leg is fixed once you are booked, and if the plan already assumes an aggressive arrival there is nothing to absorb a slip; check the realistic range for your lane in China to US shipping times before you promise anyone a receiving date.
Stagger the money so your use outlasts the slowest supplier
Here is the mistake that quietly causes more delayed containers than anything else. Five POs get placed the same week, five deposits go out the same week, and by the time production is running the buyer has already paid a chunk to everyone. The supplier with the longest lead time, the one most likely to slip, is now holding your deposit with no outstanding obligation to you until the balance is due.
Sequence the payments the way you sequence the deliveries. The supplier with the longest or least predictable lead time should have the most money still owed to them at the moment you need them to move. Where a supplier insists on payment terms that put you in the opposite position, that is worth pricing into the decision about whether they belong in this container at all.
Tie the balance to something that proves the goods exist and are where they should be. A warehouse tally report with photographs is a stronger trigger than a supplier’s own shipping notice. A copy of the bill of lading is stronger still for the final release, since it also confirms the goods actually made the sailing. If you are not clear on which document proves what and when it is issued, read up on the shipping documents involved before you write the payment terms, not after a dispute starts.
Decide the cut line before you need it
At some point during a five-supplier consolidation, four suppliers will be in the warehouse and one will not. This happens often enough that it should be a planned scenario rather than a crisis. The problem is that it surfaces within a day or two of the cutoff, when there is no time to hold a discussion across time zones.
So give the warehouse a written standing instruction while everyone is calm. Name a date and a decision: if supplier E’s cargo is not received and tallied by that date, load the four and let E follow. Or hold everything and roll to the next sailing. Or load the four and move E’s goods by air, if the goods justify it. Any of the three can be the right answer depending on whether the shipment is a coherent assortment or five independent orders that happen to travel together. What is never the right answer is finding out at the cutoff that nobody was authorised to decide.
Note the declaration consequence too. Dropping one supplier from the load at the last minute changes the invoice set, the values and the HS lines that the declaration was built on. The paperwork has to be rebuilt, not edited, which is another reason the cut line should sit comfortably before the documentation cutoff and not next to it.
What to hand your forwarder on day one
A consolidation gets quoted and planned properly when the forwarder has the picture up front. Send this before you ask for a rate, and you will get a schedule back instead of just a number:
- Each supplier’s city and pickup address, plus who pays for the leg to the warehouse
- Product description and HS code per supplier, with declared value and currency
- Whether each supplier can issue a VAT invoice and whether they export in their own name
- Estimated cartons, dimensions and gross weight per supplier, marked as estimated
- Each supplier’s promised ready date and their track record on hitting it
- Whether goods need inspection, repacking, relabelling or palletising before loading
- Destination port or door address, and your required arrival window
- Any wood packaging, batteries, liquids, magnets or brand-marked goods in the load
That last line matters more than it looks. A single supplier’s wooden crate or an unlabelled battery pack changes the compliance profile of the whole container. Better it comes up on the quote sheet than on a hold notice.
If you have suppliers in more than one Chinese city and a delivery date you cannot move, send the list above and request a consolidation quote with the dates included. The rate is the easy part. The calendar is what decides whether the container sails.
